Hwy 10, 29 and 71—Wadena construction

Wadena and Otter Tail counties

Know before you go: check 511mn.org

Current work zone

Information subject to change.

Hwy 10

Through fall

  • Open one lane each way between 620th Ave. and Oink Joint Rd.
    • Expect head-to-head traffic with lane shifts, narrow or no shoulders and multiple crews at work
  • Business access is maintained, follow signs

Hwy 71: Aldrich to Franklin Ave.

Aug. 3 to early September

  • One lane open through work zone
    • Expect narrow lanes, closed shoulders, reduced speeds, lane shifts, flaggers and changes to access; follow signs.
    • This is downtown Wadena - please slow down and watch for pedestrians and bikers!
    • Truck detour—Limited space for large-vehicle turning movements: short-term truck detour needed to complete work at the Hwy 29 and Hwy 71 intersection.
Pedestrians
  • Sidewalk closures, follow signs (usually along the adjacent side)

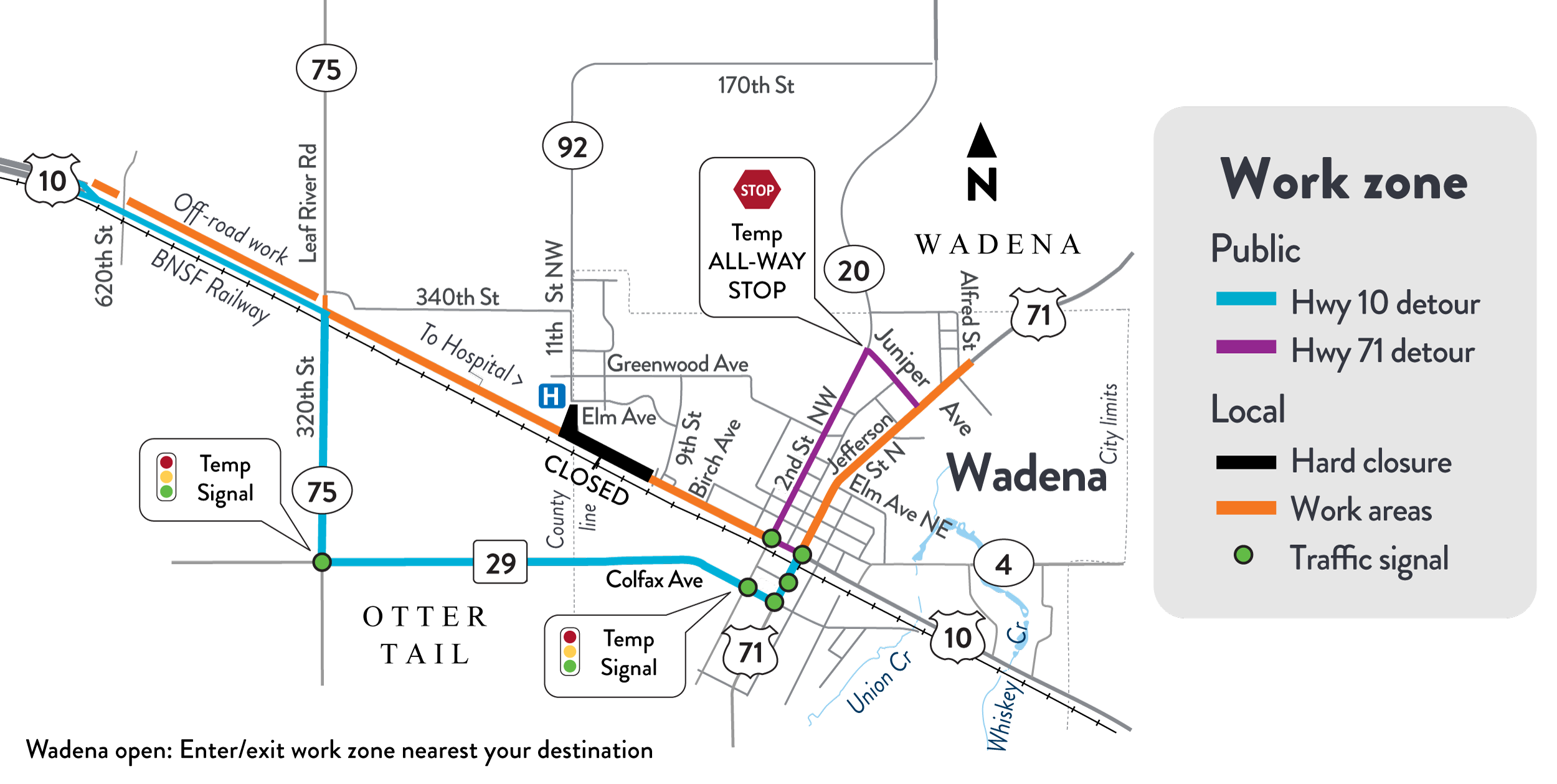

Detour map Select map image to enlarge (PNG)

Future impacts

Co. Rd. 75 access south of Hwy 10

Aug. 10 to late August

  • Closed to reconstruct the connection between the highway and the railroad.
    • Detour: Use Hwy 10, Hwy 71 and Hwy 29
      • Note: Large vehicles should use the truck detour via Second St. SW between Hwy 29 and Hwy 10.

2026 work

April - late October

2025 work zone areas map
Wadena:2026 work zone map on Hwy 10, Hwy 29 and Hwy 71. Select map PNG to enlarge

Wadena is open

Access for those who live, work or visit areas along this project will be open and maintained at all times. However, expect these changes:

  • Hard closures at times; contact businesses prior to your visit
  • Use of a side streets, alleys or back/side entrances
  • Gravel or grooved surfaces or temporary entrances
  • Pedestrians will have sidewalk closures with detours

Expect major construction on Hwy 10 west of Wadena at 620th Ave., Otter Tail County, to east of Wadena at Oink Joint Rd./140th St., Wadena County, in 2026-2027.

Hwy 10 west of Hwy 71

  • Excavate and build up road materials; replace pipes; construct road, medians and entrances, J-turn at Co. Rd. 75 and second half of roundabout at hospital - Goal: Open to four lanes by late October

Hwy 10 east of Hwy 71

  • Excavate and build up road materials; construct segments of road, entrances, half of roundabout at Harry Rich Dr., and box culverts at Union Creek and Whiskey Creek

Hwy 71 south of Hwy 10

  • Franklin to Aldrich Ave. S (35 consecutive days within June 22-Sept. 8 time frame)
    • Resurface and update the road
    • Update or install sidewalks
    • Storm sewer work
    • Update or replace signals at Hwy 29, Bryant Ave. S, Aldrich Ave.

Hwy 29

  • Hwy 71 to west limits of Wadena (40 consecutive days within June 22-Sept. 8 time frame)
    • Resurface road
    • Update/add sidewalk
    • Storm sewer work
